A plan to revamp the MBTA’s aging Back Bay station is finally entering its first phase of major construction after a decade’s worth of planning.
This work was originally planned to begin in 2023. A kick-off presentation in July of that year from developer BXP (Boston Properties) promised that Back Bay would become “a first-class transit hub of ‘airport quality’” with these renovations.
The proposed renovations would result in a 52 percent increase in seating, a 69 percent increase in dedicated waiting space, and a 49 percent increase in bike parking space, among other station improvements.

Workers have already finished a seven-month enabling, or pre-construction, phase, where crews established work zones, built electrical infrastructure, and delivered steel. Phase one of the construction work is officially underway, set to last until June.
This work will focus on the Clarendon Street exterior of the station, as well as the center and east side of the interior.
Back Bay’s Makeover Details
The $37 million dollar Back Bay Station Concourse Renovation Project is being led by BXP, the MBTA, and the City of Boston as just one part of the MBTA’s broader Back Bay Station Improvements project.
Back Bay Station sees a considerable amount of traffic – the MBTA’s Orange Line, Commuter Rail, Amtrak, and numerous buses, including the Logan Airport Express, all make stops here.
As a key rail and bus hub with a number of food and retail destinations both inside and nearby, the station is prime for restoration that meets the moment in terms of its daily visitors.
“The current station has a constrained layout and can be difficult to navigate,” the MBTA project plan’s website acknowledges.

The plan for the station’s reconstruction also focuses on air quality improvements for riders.
New jet fans in the train tunnel will pull in fresh air to the platforms, and pressurizing two stairwells between the train tracks and the upper-level concourse will prevent diesel exhaust fumes from trains from rising up into the waiting areas.
Speaking of the concourse, updates to the upper level of the station will include enhanced audio and lighting, new architectural features, updated electrical systems, improved signage and wayfinding, additional waiting areas on the concourse level, modified Orange Line fare gates, and the relocation of MBTA booths. These changes aim to improve pedestrian flow, facilitate new retail opportunities, and modernize the space.

Phases of Work

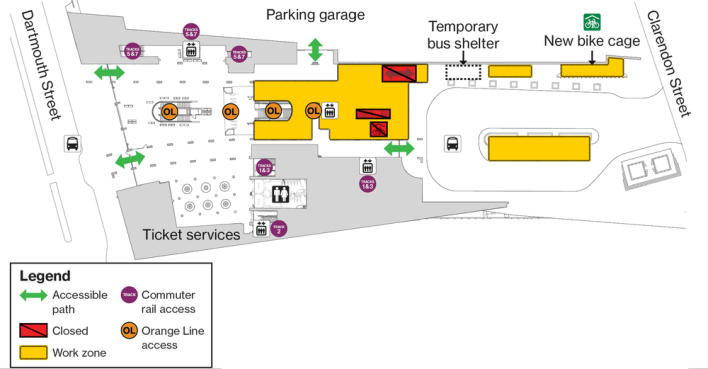

In this first phase of the work, the Clarendon Street entrance will be closed, but the elevator will remain in service, and scaffolding will be set up along the Orange Line platform.
A new bike cage at the Clarendon Street entrance will be available for public use by next week.

Following the completion of the east side in June, work crews will begin renovating the west side of the station on the Dartmouth Street side, which is slated to last from this July until April 2027.
