UPDATED: Unresolved Accessibility Issues Push Somerville Community Path Opening to Mid-June

Three people in construction vests walk down a long, straight paved pathway next to railroad tracks. In the distance the path ascends a ramp then curves out of sight, and beyond that is the skyline of downtown Boston.

Somerville’s new Community Path, looking southeast from the East Somerville Green Line station towards downtown Boston, pictured during a construction tour in September 2022.

The opening date for the long-awaited Somerville Community Path, a new multi-use trail along the new Green Line tracks in Somerville and Cambridge, has been pushed to mid-June.

MBTA officials have confirmed that additional work still needs to be done to bring the path into compliance with the Americans With Disabilities Act (ADA).

"All areas of the project were designed to be within compliance of all ADA requirements," explained an MBTA spokesperson in an email to StreetsblogMASS earlier this month. "It is not uncommon after construction is complete to discover small areas that are not in full compliance due to construction tolerances. There are two such short areas that have been identified by the project's Quality Control procedures. The contractor's repair plan has been approved by the MBTA."

The MBTA official added that the corrective work is being completed at no extra cost to the T. In a follow-up email sent Thursday, another MBTA official clarified that the T is "targeting mid-June" for completing the work, which is a necessary condition for opening the path to the public.

On Wednesday, May 3rd, Green Line Extension program manager Bill Ferrari met with Somerville's state legislative delegation on a tour of the project to provide additional detail about the outstanding work that remains to be done.

Rep. Mike Connolly of Cambridge later tweeted some photos and additional details from that meeting.

"It looks like the path is fully completed and is just sitting dormant — but as we saw in yesterday's presentation, there's still some significant work to be done, much of it pertaining to safety and accessibility," wrote Rep. Connolly. "There are incomplete guardrails, drainage installation issues, missing bollards, ADA compliance issues, etc. We were told there are about 150 items in all that require work."

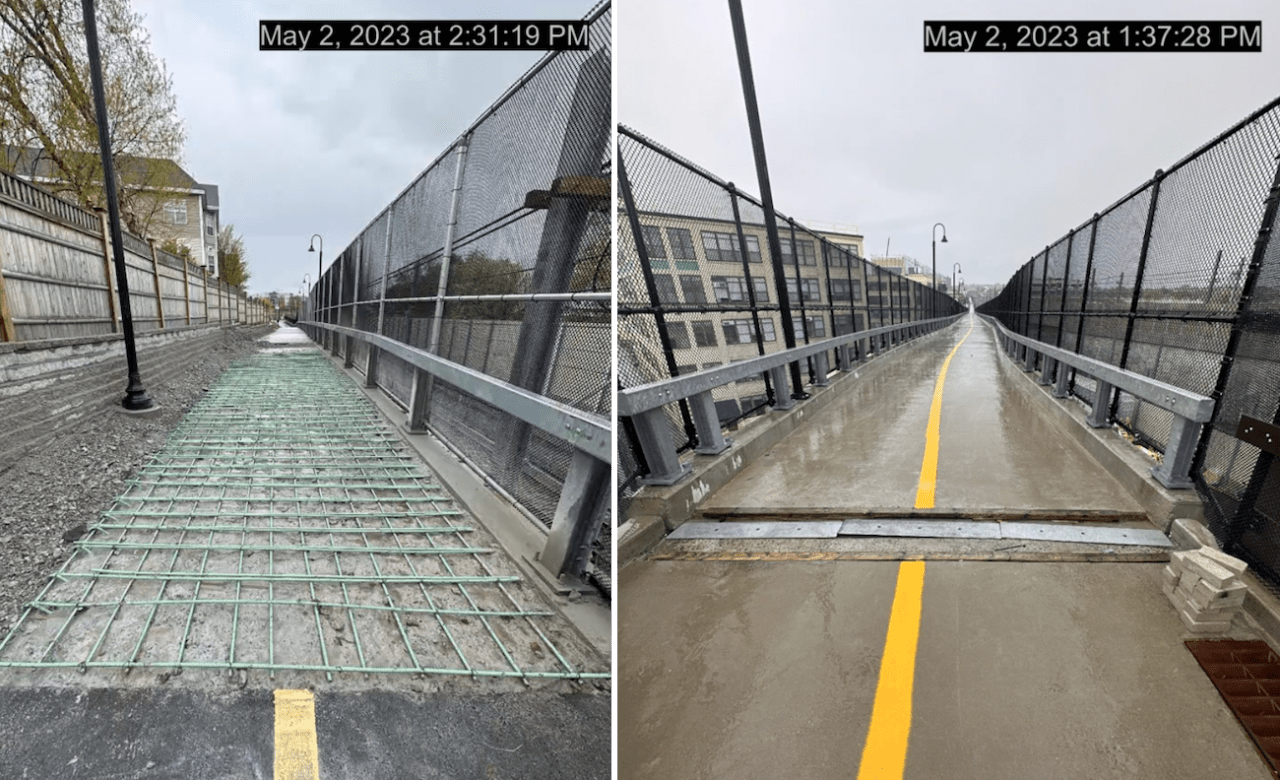

A pair of photographs show unfininshed segments of a bike path under construction. The left photo shows the asphalt path interrupted by an unpaved segment that's covered in a grid of green steel rebar, with a guardrail and chain-link fence on the right and a wooden stockade fence and streetlamps to the left. The right photo shows a section of trail on a bridge with a large gap in the paving at a bridge joint. Both sides of the trail are lined by guardrails and tall fencing and a multi-story building in the near background suggests that the bridge is several stories above the ground. Both photos are timestamped from May 2, 2023.
Recent photos of the Somerville Community Path project show some of the construction work that still remains to be finished before the path can open to users. Courtesy of Rep. Mike Connolly.
Recent photos of the Somerville Community Path project show some of the construction work that still remains to be finished before the path can open to users. Courtesy of Rep. Mike Connolly.

The Community Path Extension is one of the last unfinished elements of the MBTA’s Green Line Extension project, which has been under construction since 2017.

Once completed, the MBTA will transfer maintenance responsibilities for the new path to the City of Somerville under a lease agreement that the Somerville City Council approved this winter.

The path runs alongside the new Green Line tracks for a little over two miles, and is a segment of the much longer Massachusetts Central Rail Trail. When complete, it will connect several Somerville neighborhoods to the Alewife and Fresh Pond area in Cambridge, where several other off-street multi-use trails converge, and to downtown Boston and the Charles riverfront to the southeast.

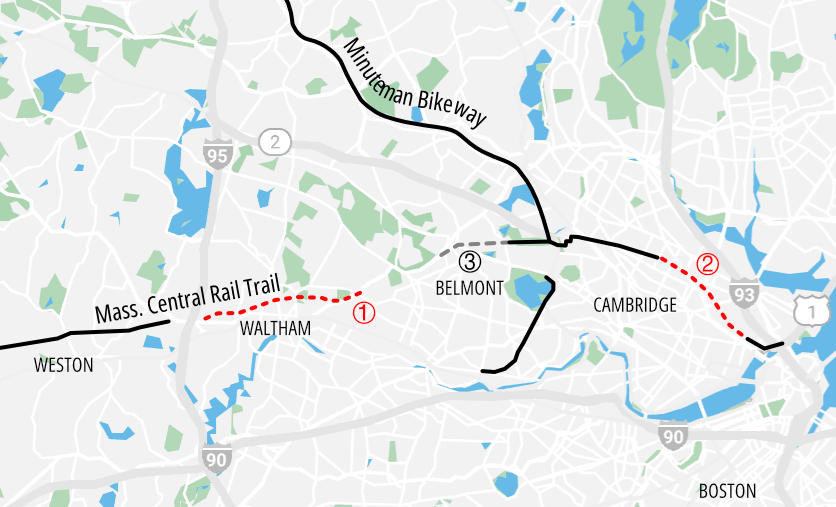

A map of Mass. Central Rail Trail projects in the greater Boston region as of July 2022. Solid black lines indicate existing off-street paths in the Mass. Central Rail Trail network; dotted red lines indicate projects currently under construction: (1), the Waltham Wayside Trail project, and (2), the Somerville Community Path, being built as part of the Green Line Extension project. The dashed gray line marked (3) in Belmont is the first phase of the Belmont Community Path, which could go under construction in 2026.
A map of Mass. Central Rail Trail projects in the greater Boston region as of spring 2023. Solid black lines indicate existing off-street paths in the Mass. Central Rail Trail network; dotted red lines indicate projects currently under construction: (1), the Waltham Wayside Trail project, and (2), the Somerville Community Path, being built as part of the Green Line Extension project. The dashed gray line marked (3) in Belmont is the first phase of the Belmont Community Path, which could go under construction in 2026.
A map of Mass. Central Rail Trail projects in the greater Boston region as of spring 2023. Solid black lines indicate existing off-street paths in the Mass. Central Rail Trail network; dotted red lines indicate projects currently under construction: (1), the Waltham Wayside Trail project, and (2), the Somerville Community Path, being built as part of the Green Line Extension project. The dashed gray line marked (3) in Belmont is the first phase of the Belmont Community Path, which could go under construction in 2026.

This story was updated at 2:30 p.m. on Thursday, May 4 to add additional information and photos from Rep. Mike Connolly.
